Building an accessory dwelling unit on a coastal Orange County lot delivers substantial returns if you clear the entitlement process, but coastal properties face a regulatory stack that inland parcels avoid. State ADU statutes have simplified approvals across most of California; coastal parcels, however, remain subject to the California Coastal Commission and its authority over setbacks, design review, and any development within the mapped coastal zone.
If you own an SFR in Newport Beach, Laguna Beach, Dana Point, or another Orange County beach city, understanding coastal setback rules determines whether you receive ministerial approval or enter a discretionary review that stretches six months and erodes project economics.

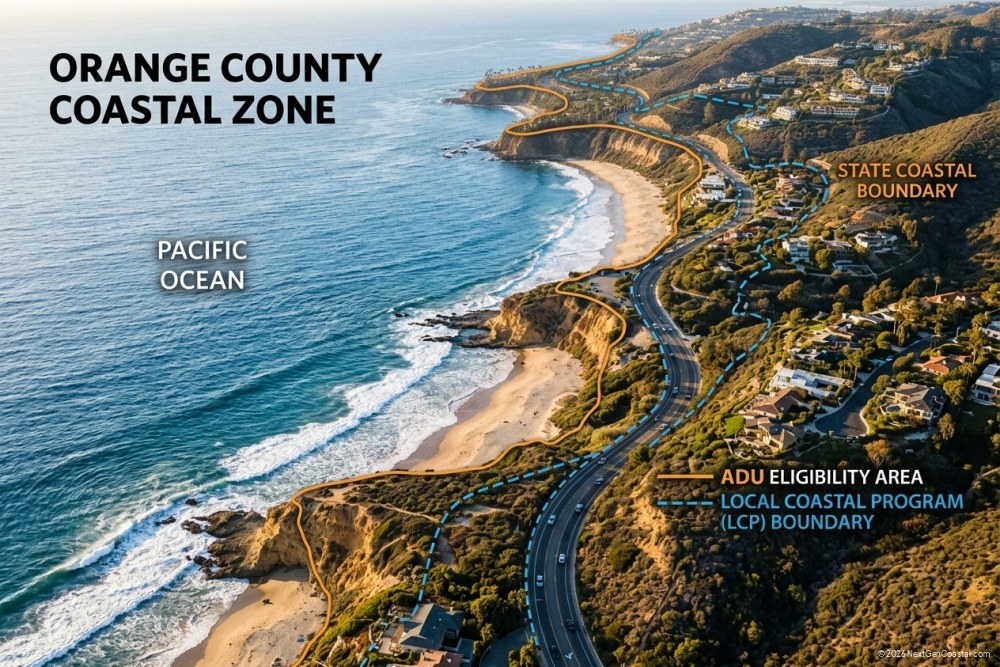

Understanding Coastal Zone Jurisdiction in Orange County

The California Coastal Act of 1976 created the California Coastal Commission and imposed a regulatory overlay that supersedes local zoning in mapped areas. Across Orange County the coastal zone penetrates inland between roughly 1,000 feet and several miles, depending on topography and municipal boundaries, capturing significant inventory in Huntington Beach, Seal Beach, and San Clemente.
Most developers miss this: a certified Local Coastal Program does not eliminate CCC review for all project types. ADUs frequently trigger Commission jurisdiction when they involve:
- New structures within 50 feet of a bluff edge
- Development that affects public coastal access
- Projects requiring variances from LCP standards
- Any construction between the first public road and the ocean
- Structures visible from designated public viewing corridors or beaches
Newport Beach, Laguna Beach, and Dana Point operate under certified LCPs, which delegate most ADU reviews to the city but impose standards reflecting CCC policy. Huntington Beach and Seal Beach hold partial certification, producing a jurisdictional patchwork where certain parcels require direct CCC involvement and others do not.
The Dual-Jurisdiction Reality
Every coastal ADU application navigates two parallel frameworks: state ADU law (Government Code §§ 65852.2 and 65852.22) and coastal development regulations. When the two conflict, coastal rules generally prevail within the zone, though recent legislation carved out protections favoring ADU construction.
AB 2221 (2020) and SB 897 (2020) restrict local agencies' ability to deny ADUs on parking or lot-coverage grounds, even in coastal areas. Both statutes, however, preserve CCC authority over coastal access, visual resources, and environmentally sensitive habitat.
Coastal Setback Requirements Explained

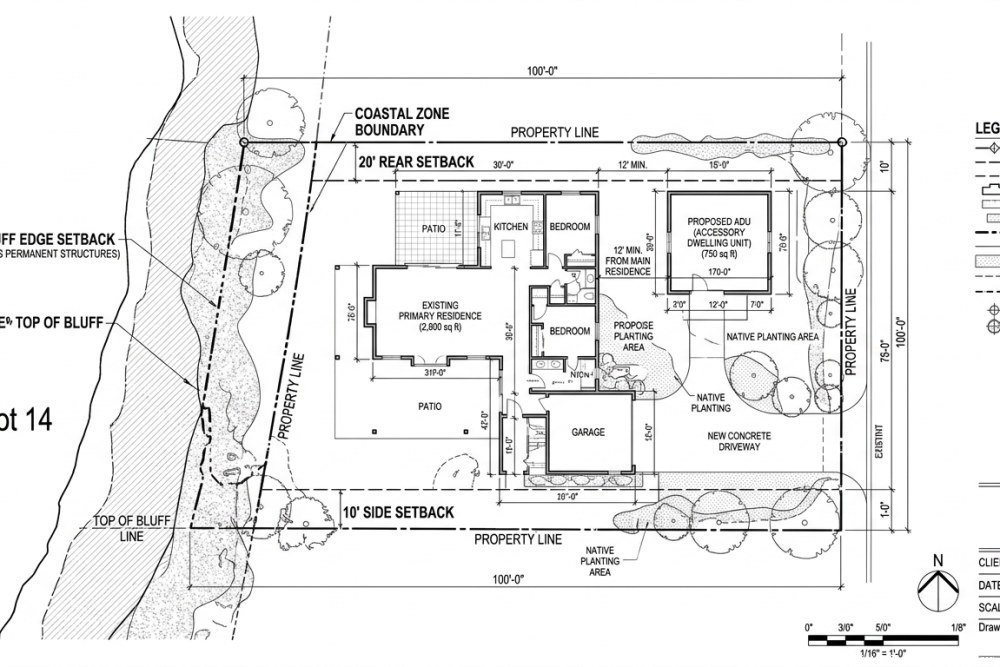

Setbacks along the Orange County coast serve multiple functions: protecting bluff stability, preserving public view corridors, maintaining coastal character, and accommodating future sea-level rise. Standard zoning setbacks address privacy and fire separation; coastal setbacks incorporate geologic hazard analysis and long-term erosion modeling.
Standard Setback Framework
Most Orange County coastal municipalities apply tiered setback rules for ADUs based on site characteristics.

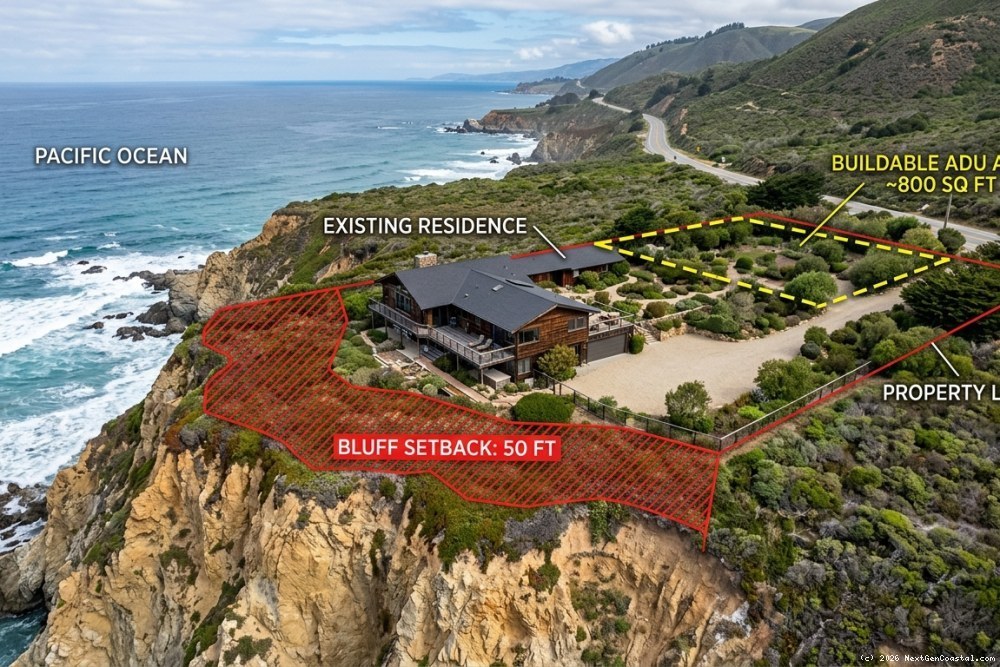

Bluff-top parcels typically require structures to sit 25 to 40 feet from the bluff edge, with the exact distance determined by geotechnical analysis. Some jurisdictions mandate setbacks sufficient to ensure 75 to 100 years of stability without armoring. ADUs on these sites match or exceed the primary residence setback rather than receiving the reduced setbacks available inland.
Non-bluff coastal properties apply standard side and rear setbacks of 3 to 5 feet for ADUs under 16 feet in height, consistent with state law. Front setbacks facing the ocean or public beaches, however, often require 10 to 20 feet to preserve streetscape and view access.
Oceanfront properties face the most restrictive rules. Many jurisdictions prohibit new structures seaward of the primary dwelling or impose minimum 20-foot setbacks from the property line nearest mean high tide. JADUs within the existing footprint become attractive here because they avoid triggering new-structure setback analysis entirely.
"The most successful coastal ADU projects I've seen start with a geotechnical assessment before architectural plans. Understanding your site's stability and required setbacks from day one prevents expensive redesigns when the coastal planner inevitably requests that analysis."
City-Specific Setback Variations
JADU conversions run roughly one-third the cost of a new detached coastal ADU, making them the default option on constrained bluff-top or oceanfront lots.
View chart data
| Category | Low estimate | High estimate |
|---|---|---|
| JADU (interior conversion) | $75k | $150k |
| New detached ADU | $250k | $400k |
Newport Beach's LCP requires ADUs to maintain the same bluff-edge setback as the primary structure, which runs 25 feet minimum in practice. On non-bluff lots, detached ADUs follow 4-foot side and rear setbacks but must sit behind the primary residence's front facade. Attached ADUs and JADUs receive greater flexibility, particularly when converting existing accessory structures.
Laguna Beach applies some of the more restrictive coastal rules. Hillside parcels (which describe most of Laguna) face additional design review. ADUs must appear subordinate to the primary dwelling in size and scale, and setbacks increase on slopes. The city prefers JADUs and attached units over new detached structures in the coastal zone.
Dana Point imposes a "coastal bluff overlay" requiring geotechnical certification for any new structure within 50 feet of a bluff edge. ADUs in this overlay need engineered foundations and deeper setbacks than the standard 25-foot rule. Outside the overlay, Dana Point offers streamlined approval with 4-foot setbacks and ministerial processing.
Huntington Beach operates under partial LCP certification, creating a split regulatory regime. Parcels in certified areas follow local ADU ordinances with standard setbacks; parcels in uncertified areas require coastal development permits directly from the CCC for most ADUs. Timeline and cost differences hinge on which side of the certification boundary your lot falls.
ADU vs. JADU: Entitlement Strategies for Coastal Properties
The ADU versus JADU distinction becomes critical in coastal zones. Avoiding new-structure triggers can mean the difference between six-month approval and two-year entitlement.
JADU Advantages in the Coastal Zone
Junior ADUs, capped at 500 square feet and carved from the existing primary residence or attached garage, offer several advantages on coastal parcels:
- No setback analysis required because JADUs occupy existing building footprints and do not trigger coastal setback review or geotechnical studies
- Ministerial approval in most coastal cities for compliant applications, avoiding discretionary design review
- Lower CCC scrutiny since interior conversions rarely implicate coastal access, visual resources, or bluff stability
- Faster timelines of 60 to 90 days versus 6 to 12 months for detached coastal ADUs
- Lower cost, with conversion budgets running one-third to one-half the cost of new detached construction
On oceanfront or bluff-top lots where new-structure setbacks consume most buildable area, JADUs often represent the only economically viable accessory unit. The 500-square-foot cap matters less in high-value coastal markets where small units command premium rents.
Detached ADU Considerations
Site conditions permitting, detached ADUs deliver advantages worth the complex entitlement:
- Up to 1,200 square feet or larger under local ordinance allowances
- Separate utility metering and true rental independence
- Two-story design potential maximizing ocean views
- Higher rental income in coastal markets
- Greater flexibility for future sale as a separate legal unit
Conduct early setback feasibility diligence. Order a preliminary title report to identify recorded setback easements, then overlay your city's coastal setback rules and CCC jurisdiction triggers. Buildable area often shrinks dramatically once all coastal setbacks apply.
Navigating AB 2221 and SB 897 in Coastal Contexts
Recent state legislation provides important protections for ADU developers in coastal zones, though the limitations matter.
Parking Requirement Relief
AB 2221 prohibits local agencies from requiring more than one parking space per ADU and eliminates parking requirements entirely for ADUs within one-half mile of public transit. This applies in coastal zones, overriding LCP provisions that previously required two spaces for larger units.
The CCC, however, retains authority to require parking where necessary to protect coastal access, which in practice means:
- ADUs near beach access points face parking requirements to prevent spillover into public beach parking areas
- Properties in areas with documented parking constraints must demonstrate adequate on-site parking capacity
- Tandem parking and creative solutions such as car stackers are generally acceptable substitutes
Lot Coverage and Setback Protections
SB 897 limits local agencies' ability to apply lot coverage, floor area ratio, or open space requirements that would preclude construction of an 800-square-foot ADU with 4-foot side and rear setbacks. This creates a floor of development rights applying even in coastal zones.
In practice, cities cannot use lot coverage limits to deny ADUs meeting state minimum standards, but they retain authority to apply coastal-specific setbacks for bluff protection, visual resource preservation, and hazard avoidance. The law protects your right to build; it does not guarantee you can build in your preferred location on the lot.
The Coastal ADU Entitlement Process: Timeline and Milestones

Understanding the approval pathway allows realistic project timeline and budget planning.
Entitlement review dominates the coastal ADU timeline; construction runs in parallel after permits issue.
View chart data
| Category | Weeks |
|---|---|
| Phase 1 · Pre-Application Due Diligence | 4 |
| Phase 2 · Design & Engineering | 12 |
| Phase 3 · Entitlement Review | 24 |
| Phase 4 · Construction | 24 |
Phase One: Pre-Application Due Diligence (Weeks 1-4)
Before commissioning architectural plans, invest in understanding site constraints:
- Order a preliminary title report and survey to identify all easements and recorded setbacks
- Request a pre-application meeting with city planning and building departments
- Determine whether your parcel lies within the coastal zone and which agency holds jurisdiction
- Obtain geotechnical screening for bluff-top or hillside properties
- Review neighborhood context and recent ADU approvals in the area
This phase runs a few thousand dollars but identifies fatal constraints before design investment.
Phase Two: Design and Engineering (Weeks 5-16)
Engage architects and engineers experienced in coastal projects:
- Architectural plans demonstrating compliance with setbacks, height limits, and design standards
- Geotechnical report (where required) analyzing bluff stability and foundation requirements
- Drainage and utility plans showing no increase in runoff or coastal hazards
- Visual impact analysis for properties with ocean views or public visibility
- Landscape plans featuring drought-tolerant, coastal-appropriate vegetation
Coastal-experienced design professionals command higher fees than standard residential architects, but their familiarity with CCC and LCP requirements reduces revision cycles and can shorten overall timeline.
Phase Three: Entitlement Review (Weeks 17-40)
Timeline varies significantly by project complexity and jurisdiction.
Ministerial JADUs receive 60 to 90 days for building permit approval, with no discretionary review or public hearing required.
Ministerial detached ADUs outside sensitive areas run 90 to 120 days for building department review with planning sign-off on zoning compliance.
Projects requiring a Coastal Development Permit stretch 6 to 12 months, including public notice, potential appeals, and CCC review if the Commission holds jurisdiction. Expect this pathway if your ADU involves:
- New structures within bluff setback areas requiring variances
- Properties between the first public road and the sea
- Projects visible from public beaches or coastal access points
- Sites containing environmentally sensitive habitat areas
Phase Four: Construction (Months 10-16)
Coastal construction faces unique challenges:
- Limited construction access in dense beach neighborhoods
- Seasonal restrictions during bird nesting periods, running March through August in most jurisdictions
- Higher material and labor costs attributable to coastal location
- Salt-air corrosion requiring upgraded materials and finishes
- Strict erosion control and runoff management during construction
Construction budgets and timelines run higher than inland projects; add margin for weather delays and access constraints.
Common Entitlement Pitfalls and How to Avoid Them

Pitfall #1: Assuming State ADU Law Supremacy
Developers frequently assume state law requiring ministerial ADU approval overrides coastal regulations. This produces plan submissions ignoring bluff setbacks or visual impact requirements, resulting in denials or expensive redesigns.
Treat coastal requirements as the baseline, with state ADU law providing additional protections against overly restrictive local standards. Your project must satisfy both frameworks.
Pitfall #2: Inadequate Geotechnical Analysis
Submitting plans without geotechnical reports for bluff-top properties, or relying on outdated reports from primary residence construction, triggers automatic requests for additional information and delays approval by months.
Commission a new geotechnical study specifically addressing ADU foundation requirements and bluff stability. Verify the geotechnical engineer holds a California license and understands CCC standards.
Pitfall #3: Ignoring Public Access Implications
ADUs blocking traditional public access paths (including informal ones) or eliminating parking serving beach access face CCC scrutiny and potential denial.
Document existing access patterns and demonstrate your ADU maintains or improves public access. If your property has historically provided informal beach access, consider incorporating a formal access easement into the project to gain CCC support.
Pitfall #4: Underestimating Visual Impact Review
Two-story ADUs or structures breaking the roofline of surrounding development trigger discretionary design review even when they meet height limits and setbacks.
Prepare visual simulations from public viewing areas showing your ADU in context. Design to match or remain subordinate to the primary residence in height, bulk, and architectural style. Single-story designs with low-profile rooflines receive faster approval in most coastal jurisdictions.
Maximizing Value: Coastal ADU Investment Returns
Despite entitlement complexity, coastal ADUs deliver strong returns in Orange County beach cities.
Rental Income Potential
Laguna Beach ocean-view units lead the OC coastal ADU market; Huntington Beach anchors the low end among Orange County beach cities.
View chart data
| Category | Monthly low | Monthly high |
|---|---|---|
| Newport Beach | $2,800 | $4,500 |
| Laguna Beach | $3,200 | $5,000 |
| Dana Point | $2,500 | $3,800 |
| Huntington Beach | $2,400 | $3,600 |
A development investment producing $3,500 per month in rental income can generate substantial cash-on-cash returns before considering property value appreciation, potentially exceeding many alternative real estate investments.
Property Value Enhancement
Coastal properties with legal ADUs command premiums over comparable properties without accessory units. The combination of rental income and expanded living space appeals to multigenerational buyers and investors.
For properties in the $2 million to $4 million range (characteristic of coastal Orange County SFRs), adding a well-designed ADU can increase property value above the all-in development cost for most projects.
Portfolio Strategy Considerations
Coastal ADUs serve multiple investment strategies:
- Cash flow enhancement through long-term rentals to professionals and small families seeking coastal lifestyle without full-home costs
- Flexible use as guest accommodations during owner occupancy, with rental income potential when the primary residence sits vacant
- Multigenerational living arrangements as aging parents seek coastal proximity while maintaining independence
- Future subdivision potential, as legislative trends suggest ADU condominiumization may become permissible, creating future value optionality
Working with Coastal-Experienced Professionals
Coastal ADU development demands a team with specific expertise.
Architect Selection
Prioritize architects with demonstrated coastal project experience and existing relationships with local planning departments. Request references from recent ADU projects in your specific city and review their success rate with ministerial versus discretionary approvals.
Architectural services for a coastal ADU run $15,000 to $35,000, with fees at the higher end for complex sites requiring extensive engineering coordination.
Expediter Value Proposition
Permit expediters specializing in coastal jurisdictions can reduce approval timelines through strategic application preparation and proactive coordination with planning staff. Their fees may be offset through reduced holding costs and faster income generation.
Property Management Considerations
Coastal ADUs attract premium tenants but require management expertise in luxury rental markets. Salt-air maintenance, beach access expectations, and seasonal demand fluctuations differ substantially from inland rental management.
Specialized property management services for coastal ADUs address unique factors including maintenance scheduling for coastal-specific issues such as HVAC salt-air corrosion and exterior finish degradation, while applying local market expertise for tenant placement and retention.
The Future Regulatory Landscape
Several legislative and regulatory trends will shape coastal ADU development over the next several years.
Sea-Level Rise Adaptation Requirements
The CCC increasingly incorporates sea-level rise projections into coastal development permits. Future ADU approvals may require demonstration that structures will remain safe and accessible through 2070 to 2100 under moderate sea-level rise scenarios.
This translates to elevated foundations, flood-resistant construction, or deed restrictions acknowledging future hazards. Early adoption of these standards can streamline approvals and protect long-term investment value.
ADU Law Evolution
Pending legislation would further limit local agencies' ability to restrict ADUs based on architectural compatibility and design standards, potentially affecting some LCP provisions. Core coastal protections around bluff stability, public access, and environmentally sensitive areas are expected to remain intact.
Local Coastal Program Updates
Several Orange County coastal cities are updating their LCPs to accommodate ADU development while maintaining coastal protections. Newport Beach and Dana Point have proposed amendments creating clearer ministerial pathways for ADUs outside sensitive areas, potentially reducing approval timelines.
Conclusion: A Strategic Approach to Coastal ADU Development
Coastal Orange County ADU development requires working through complex, overlapping regulatory frameworks. Properties that successfully add accessory units in beach cities generate premium rental income, substantial value appreciation, and flexible use options unavailable in inland markets.
Success hinges on treating coastal setback requirements and CCC jurisdiction as design parameters from day one rather than obstacles to overcome after plans are complete. Invest in early due diligence, engage coastal-experienced professionals, and structure your project to align with both state ADU law protections and coastal resource preservation goals.
For SFR owners willing to work through the entitlement process strategically, coastal ADUs represent one of the highest-value development opportunities in California real estate, combining multifamily cash flow with prime coastal property appreciation.
