Huntington Beach ADU Permits Under CCC Jurisdiction 2026

Navigate coastal development permits, setback rules, and AB 2221 exemptions for beach-zone accessory units

CCC Jurisdiction Boundaries in Huntington Beach

The California Coastal Commission's authority in Huntington Beach derives from the California Coastal Act of 1976, which established state oversight for development within defined coastal zones to protect public access, marine resources, and coastal-dependent land uses. In Huntington Beach, the coastal zone boundary runs roughly parallel to Pacific Coast Highway, extending inland approximately 1,000 feet in most areas but widening near wetlands, bluffs, and environmentally sensitive habitat areas (ESHA). Properties seaward of this line fall under dual jurisdiction: the city processes building permits and enforces local zoning, while the CCC reviews projects for consistency with the certified Local Coastal Program (LCP).

For ADU developers in CCC jurisdiction, this jurisdictional split creates a two-stage approval process. The city's Planning Division first determines whether your proposed unit qualifies for ministerial approval under state ADU law—meaning it meets objective design standards without discretionary review. If the project qualifies and sits outside the coastal zone, you receive approval within 60 days. But if your parcel lies within CCC jurisdiction, even a ministerially approved ADU triggers a coastal development permit (CDP) application, adding environmental review, public notice periods, and potential appeal windows that extend timelines by four to eight months.

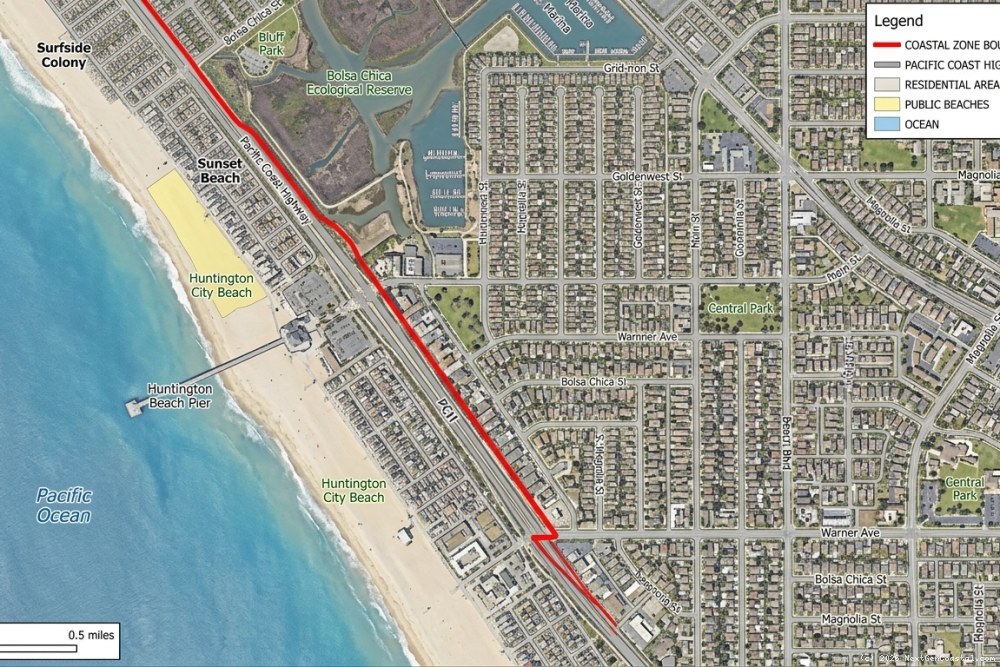

Aerial map of Huntington Beach showing California Coastal Commission jurisdiction boundary line in relation to Pacific Coast Highway and residential neighborhoods
The CCC coastal zone boundary in Huntington Beach extends inland from the shoreline, capturing most properties west of PCH and triggering dual-jurisdiction review for ADU projects.

The 2026 landscape introduces additional complexity because AB 2221 (effective January 2025) prohibits local agencies from requiring CDPs for ADUs that meet specific criteria, creating a narrow exemption pathway within the coastal zone. To qualify, your ADU must be located on a lot with an existing single-family residence, not exceed 800 square feet (detached) or 500 square feet (attached), maintain a 16-foot height limit, and observe four-foot side and rear setbacks. Projects meeting these thresholds bypass CCC review entirely, reverting to the city's 60-day ministerial timeline even within the coastal zone.

This exemption represents a significant shift in coastal ADU feasibility. Prior to AB 2221, virtually every accessory unit west of PCH required a CDP, with associated costs ranging from $8,000 to $22,000 in application fees, consultant reports, and extended soft costs. The new exemption corridor allows smaller, code-compliant units to proceed without coastal review, compressing approval timelines and reducing entitlement risk for projects that fit the dimensional envelope.

Coastal Setback Requirements and Waiver Pathways

Coastal setback regulations in Huntington Beach serve dual purposes: protecting the public's visual access to the ocean and preserving the structural integrity of development as bluffs erode and sea levels rise. The city's LCP establishes a 25-foot bluff-edge setback for new structures on oceanfront parcels, measured from the bluff's landward edge as determined by a licensed geotechnical engineer. For non-bluff coastal properties, standard residential setbacks apply (typically five feet side, 15 feet rear), but the CCC retains authority to impose additional buffers near wetlands, dunes, or ESHA.

ADU projects within the coastal zone must navigate these setback requirements alongside state ADU law, which mandates that cities allow four-foot side and rear setbacks for accessory units regardless of underlying zoning. The tension between state ADU mandates and coastal resource protection creates a hierarchy of rules: AB 2221's four-foot setback allowance applies within the coastal zone, but only for ADUs that meet the exemption criteria (800 sf detached, 500 sf attached, 16-foot height). Larger units or those exceeding height limits revert to standard LCP setbacks, which may require variances or design modifications to achieve compliance.

For properties with constrained lot dimensions—common in older Huntington Beach beach-close neighborhoods platted before modern setback rules—the four-foot allowance unlocks ADU feasibility that wouldn't exist under standard 5–10 foot side-yard requirements. A 4,500-square-foot lot with a 1,800-square-foot primary residence and 15-foot rear setback might have insufficient buildable area for a detached ADU under conventional zoning, but the four-foot side allowance creates a 20-by-40-foot building envelope (800 sf) that fits within the exemption threshold.

"The AB 2221 setback waiver is the single most important feasibility unlock for coastal ADU projects. We're seeing Huntington Beach lots that were previously unbuildable now accommodate 750-square-foot detached units without triggering CCC review—compressing entitlement from nine months to 60 days and cutting soft costs by $30,000 or more."

Bluff-top properties face additional scrutiny. Even if your ADU qualifies for the AB 2221 exemption, the CCC may assert jurisdiction if the unit sits within 50 feet of a coastal bluff, arguing that geologic stability and visual resource protection override the state ADU exemption. In practice, this means oceanfront parcels in areas like Sunset Beach or the Huntington Cliffs neighborhood should assume CDP review regardless of unit size, and budget for geotechnical reports ($4,500–$8,000) and visual impact assessments ($3,000–$6,500) as part of the entitlement package.

JADU Conversion Strategy for Coastal Properties

Junior accessory dwelling units (JADUs) offer a distinct entitlement pathway that sidesteps many coastal permitting hurdles. Defined under California Government Code Section 65852.22, a JADU is a residential unit of 500 square feet or less created entirely within the existing walls of a single-family residence, typically by converting a bedroom, bonus room, or attached garage. Because JADUs involve no new exterior construction or lot coverage expansion, they generally avoid triggering coastal development permits even within CCC jurisdiction.

Interior view of a converted JADU showing kitchenette with compact appliances, Murphy bed, and large window overlooking coastal landscaping
JADU conversions leverage existing interior space within the primary residence, avoiding new construction triggers that would require coastal development permits in CCC jurisdiction areas.

For Huntington Beach coastal properties, JADU conversions present three strategic advantages. First, they bypass the AB 2221 dimensional constraints—you're not limited to 800 square feet detached or 500 square feet attached, because the JADU exists within the primary structure's existing footprint. Second, they avoid the bluff-edge setback analysis entirely, since no new foundation or structural elements encroach toward the bluff. Third, they typically qualify for over-the-counter building permit issuance, with approval timelines measured in weeks rather than months.

The JADU pathway does impose specific design requirements. The unit must include a separate entrance (either existing or newly created), an efficiency kitchen (sink, cooking appliance, food storage—but a full kitchen is permitted), and sanitary facilities that may be shared with the primary residence. Huntington Beach allows one JADU per single-family lot in addition to one ADU, meaning a coastal property owner can pursue both a detached 800-square-foot ADU (under AB 2221 exemption) and a 500-square-foot JADU conversion simultaneously, creating two rentable units without triggering CDP review for either.

The financial calculus favors JADUs in high-cost coastal markets. A typical JADU conversion—repurposing a 450-square-foot bonus room above a garage—runs $65,000 to $95,000 all-in (kitchen, bathroom, separate entrance, permits), compared to $180,000 to $280,000 for a new 800-square-foot detached ADU. The JADU achieves rent of $2,200 to $2,800 per month in Huntington Beach's coastal neighborhoods, delivering a 28–35% cash-on-cash return in year one. For owners prioritizing speed to market and capital efficiency, the JADU conversion often outperforms new construction on an ROI basis, particularly when CCC jurisdiction would otherwise extend entitlement timelines.

AB 2221 Exemption Criteria and Dimensional Limits

AB 2221's coastal zone exemption hinges on meeting five cumulative criteria, each designed to limit the scale and impact of ADUs that bypass CCC review. Understanding these thresholds—and how to design to them—determines whether your Huntington Beach coastal project proceeds ministerially or enters the CDP queue.

The 800-square-foot detached limit is measured as gross floor area, including interior walls but excluding covered patios, decks, and detached storage structures under 150 square feet. A two-story detached ADU with a 400-square-foot footprint per floor qualifies; a 900-square-foot single-story unit does not. For attached ADUs, the threshold drops to 500 square feet, measured from the interior face of exterior walls. This dimensional cap aligns with JADU maximums, creating parity between attached ADUs and JADU conversions in terms of exemption eligibility.

The 16-foot height limit is measured from finished grade to the roof's highest point, excluding chimneys and antennas. In practical terms, this accommodates a single-story ADU with a vaulted ceiling or a compact two-story unit with 8-foot plate heights and a low-slope roof. Huntington Beach's standard residential height limit is 25 feet (two stories), so the AB 2221 cap represents a meaningful constraint for coastal projects. Owners seeking to maximize square footage within the 800-sf envelope often opt for two-story designs, but must carefully detail roof pitch and foundation elevation to stay under the 16-foot threshold.

The four-foot side and rear setback requirement overrides more restrictive local zoning, but does not waive front-yard setbacks, which remain at 20 feet in most Huntington Beach residential zones. This asymmetry matters for lot configuration: a narrow 50-foot-wide parcel can accommodate a 20-foot-wide detached ADU (50 ft minus 4 ft side setbacks on each side minus 2 ft for eaves = 20 ft buildable width), but the unit must sit behind the primary residence's front building line. Corner lots face additional complexity, as the "front" setback applies to both street-facing sides, often limiting ADU placement to the rear quarter of the lot.

CDP Application Process for Non-Exempt ADUs

When your Huntington Beach ADU exceeds AB 2221 thresholds—whether due to size, height, or location—you enter the coastal development permit process. The CDP application begins with a pre-application meeting at the city's Planning Division, where staff review your site plan, confirm coastal zone status, and identify which LCP policies govern your parcel. For ADU projects, the most common policy triggers involve visual resource protection (ocean view corridors), public access (ensuring the ADU doesn't block lateral beach access), and hazard avoidance (geologic stability on bluff parcels).

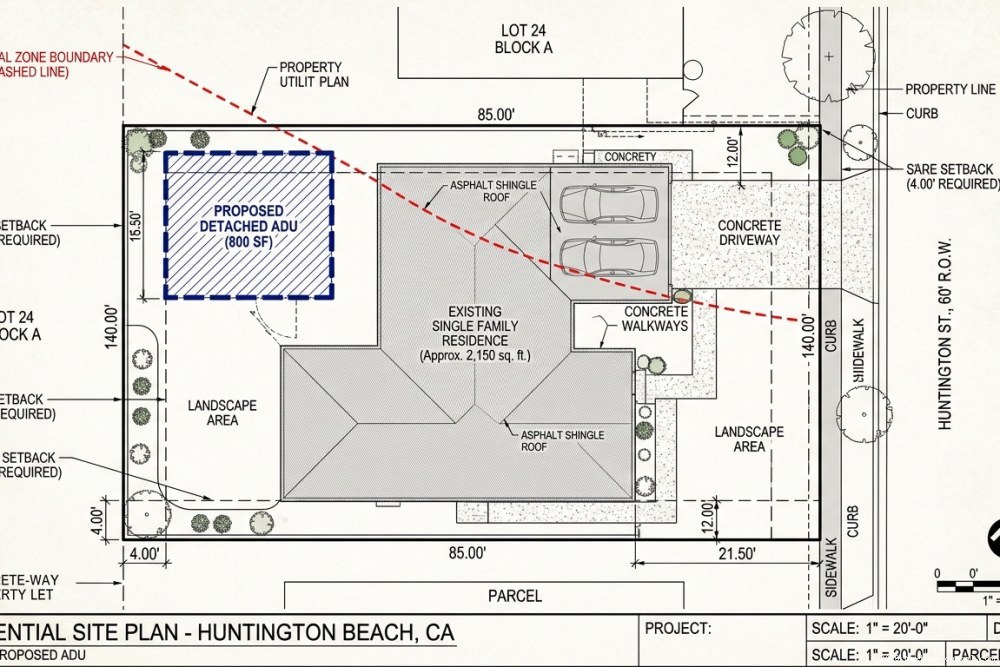

Architectural site plan showing proposed ADU location, setback dimensions, and coastal zone boundary line with existing single-family residence
CDP applications require detailed site plans showing the ADU's relationship to coastal zone boundaries, setback lines, and environmentally sensitive areas—documentation that drives the CCC's consistency review.

The formal CDP application requires a project description, site plan, elevations, landscape plan, and a consistency analysis demonstrating compliance with the LCP's certified policies. Application fees for ADU CDPs in Huntington Beach start at $3,200 for projects under 1,000 square feet, with additional charges for environmental review if the project triggers CEQA (rare for single ADUs, but possible near ESHA). You'll also need a biological assessment ($2,500–$4,500) if your lot abuts wetlands or dunes, and a visual impact analysis ($3,000–$6,500) if the ADU is visible from a public viewing area or beach access point.

Once submitted, the city has 30 days to deem the application complete. The CDP then enters a public review period, with notice mailed to property owners within 300 feet and posted on-site. The city's Planning Commission typically hears ADU CDPs within 60–90 days of completeness, though complex projects or those generating public comment may require continuances. If approved, the CDP includes a 10-business-day appeal period during which any interested party can appeal the decision to the California Coastal Commission. Approximately 8–12% of Huntington Beach ADU CDPs are appealed to the CCC, usually by neighbors citing view impacts or by environmental groups alleging LCP inconsistencies.

If appealed, the CCC schedules a hearing at its monthly meeting (typically in San Francisco, though some hearings occur in Southern California). The Commission can uphold the city's approval, modify conditions, or deny the permit outright. This appeal window adds three to six months to the entitlement timeline and introduces uncertainty that many developers find unacceptable. For this reason, projects that can be redesigned to meet AB 2221 exemption criteria—even if it means reducing size from 1,000 sf to 800 sf—often choose the smaller envelope to avoid CDP risk entirely.

SB 897 Impact on Coastal ADU Approvals

SB 897, effective January 2023, amended California's ADU law to prohibit local agencies from requiring owner-occupancy for ADUs or JADUs for five years from the date of the bill's passage (through January 2028). For Huntington Beach coastal properties, this provision removes a significant barrier to ADU investment returns. Prior to SB 897, many coastal cities—including Huntington Beach—required that either the primary residence or the ADU be owner-occupied, limiting the ability to rent both units simultaneously or to acquire a property specifically for ADU development and dual-rental income.

The owner-occupancy prohibition applies to all ADUs approved after January 1, 2023, regardless of coastal zone location, meaning even CDPs processed through the CCC cannot impose occupancy restrictions as a condition of approval. This legislative override creates a clear investment thesis for coastal ADU projects: acquire a single-family residence in Huntington Beach's coastal zone, add an 800-square-foot detached ADU under AB 2221 exemption, and rent both units to unrelated tenants, generating combined gross income of $6,800–$8,500 per month (primary residence $4,200–$5,200, ADU $2,600–$3,300) on a property that might have previously been limited to single-family occupancy.

The SB 897 window also influences hold-period strategy. Developers acquiring coastal SFR properties for ADU conversion in 2024–2025 can underwrite five years of dual-rental income without owner-occupancy constraints, then reassess in 2028 whether to sell, continue renting, or occupy one unit if the law sunsets. This certainty supports higher acquisition prices and more aggressive pro formas, particularly in Huntington Beach neighborhoods where lot values ($800,000–$1.4 million for 5,000–7,000 sf parcels) require dual-income streams to achieve target returns.

Accessory Structure Classification and Conversion Opportunities

Huntington Beach's zoning code distinguishes between accessory dwelling units (habitable living space with kitchen and bathroom) and accessory structures (garages, workshops, storage buildings). This classification matters for coastal projects because converting an existing accessory structure to an ADU often avoids new construction triggers that would require CDP review, even if the converted structure exceeds AB 2221's 800-square-foot threshold.

The conversion pathway works as follows: if your coastal property includes a detached garage, workshop, or pool house built before the current LCP was certified (typically pre-1985 in Huntington Beach), converting that structure to an ADU is treated as a change of use rather than new development. The city requires a building permit to add kitchen and bathroom plumbing, upgrade electrical service, and ensure the structure meets current residential building codes, but the project generally doesn't trigger a CDP because the building envelope, setbacks, and lot coverage remain unchanged.

Exterior view of a converted detached garage ADU with new windows, Dutch door entry, and coastal-style board-and-batten siding in a Huntington Beach backyard
Existing accessory structure conversions—transforming garages or workshops into ADUs—often bypass CDP requirements by maintaining the original building footprint and avoiding new coastal zone impacts.

This exemption is particularly valuable for oversized garages common in older Huntington Beach neighborhoods. A 900-square-foot detached three-car garage built in 1978 can be converted to a two-bedroom ADU without triggering AB 2221's 800-sf limit, because the structure predates current coastal regulations and the conversion doesn't expand the building footprint. The result: a larger, more valuable rental unit (commanding $3,200–$3,800/month vs. $2,600–$3,000 for an 800-sf new-build ADU) with faster entitlement and lower construction costs (conversion runs $140–$180/sf vs. $225–$350/sf for ground-up construction).

The accessory structure conversion strategy requires careful documentation. You'll need to prove the structure's age through building permits, tax records, or title reports, and demonstrate that it was legally constructed under the zoning rules in effect at the time. Unpermitted structures—common in beach communities where owners added garages or workshops without permits decades ago—cannot use this pathway and must either be legalized (expensive and time-consuming) or demolished and replaced with a code-compliant ADU.

Entitlement Timeline Comparison: Exempt vs. CDP Routes

Permit Timeline Analysis
AB 2221 Exempt vs CDP Route: Entitlement Timeline Comparison

Exempt ADUs receive permits in 60-70 days while CDP-required projects take 8-14 months, creating 6-12 months of additional soft costs.

AB 2221 Exempt vs CDP Route: Entitlement Timeline Comparison
LabelDays to Construction Start
AB 2221 Exempt (800 sf)70.00
CDP Route - No Appeal (1,200 sf)270.00
CDP Route - With Appeal (1,200 sf)420.00

The decision to design within AB 2221 exemption criteria versus pursuing a larger ADU through the CDP process hinges on timeline tolerance and project economics. An 800-square-foot detached ADU meeting exemption thresholds follows this approval sequence in Huntington Beach:

  • Week 1–2: Submit ministerial ADU application with site plan, elevations, and AB 2221 compliance checklist
  • Week 3–4: City completeness review; respond to any plan-check corrections
  • Week 5–8: Building Division plan review (structural, electrical, plumbing, energy code)
  • Week 9: Permit issuance; pay permit fees ($8,500–$12,000 for 800-sf ADU)
  • Week 10: Begin construction

Total timeline: 60–70 days from application to permit issuance, assuming a complete and code-compliant submittal. By contrast, a 1,200-square-foot detached ADU requiring a CDP follows this extended sequence:

  • Month 1: Pre-application meeting; prepare CDP application and supporting studies
  • Month 2: Submit CDP application; city completeness review
  • Month 3–4: Public notice period; Planning Commission hearing preparation
  • Month 5: Planning Commission hearing; CDP approval with conditions
  • Month 5–6: 10-day appeal period; if appealed, CCC hearing scheduled 2–4 months out
  • Month 6–7: Building permit application (concurrent with CDP finalization)
  • Month 8–9: Building permit issuance
  • Month 10: Begin construction (if no appeal) or Month 12–14 (if CCC appeal resolved favorably)

Total timeline: 8–14 months from pre-application to construction start, depending on appeal activity. This six-to-twelve-month delta carries significant soft costs—property taxes, insurance, loan interest, and opportunity cost—that often exceed $40,000 on a $1.2 million coastal acquisition. For developers operating on institutional timelines or using bridge financing, the CDP route's uncertainty and extended hold period can render projects infeasible even when the larger ADU would generate higher NOI.

Design Strategies for Maximum Exemption Compliance

Designing an 800-square-foot ADU that maximizes livability while staying within AB 2221's dimensional envelope requires intentional space planning and material choices. The most successful Huntington Beach coastal ADUs employ these strategies:

Two-story layouts with 400 sf per floor create distinct living and sleeping zones without exceeding the 16-foot height limit. A ground floor with open kitchen/living (280 sf) and full bathroom (80 sf) plus a second-floor bedroom (320 sf) and closet (80 sf) delivers a functional one-bedroom unit that feels significantly larger than its square footage suggests. Vaulted ceilings on the upper floor (possible within the 16-foot envelope using a 5:12 roof pitch) add volume and natural light.

Outdoor living space integration extends the usable area without counting against the 800-sf cap. A 120-square-foot covered deck or patio—structurally separate from the ADU but accessed through sliding glass doors—provides dining and lounging space that coastal tenants value highly. Because covered outdoor areas aren't included in gross floor area calculations, they offer a feasibility unlock for projects on smaller lots where maximizing the ADU footprint would violate setbacks.

High-efficiency mechanical systems reduce the space consumed by HVAC equipment, water heaters, and laundry. A ductless mini-split heat pump eliminates the need for a mechanical closet (saving 15–20 sf), while a tankless water heater and stacked washer-dryer combo fit within a 24-inch-wide utility alcove. These space savings allow more area for living functions—critical when every square foot counts toward the 800-sf cap.

Coastal-appropriate materials and finishes ensure the ADU integrates with the primary residence and neighborhood character, reducing the risk of design-based objections during the ministerial review. Fiber cement siding, aluminum-clad windows, and standing-seam metal roofing deliver the beach-contemporary aesthetic Huntington Beach tenants expect while meeting the city's durability and maintenance standards for coastal-zone construction.

Financial Modeling: Coastal ADU Development Returns

Investment Returns
5-Year Equity Gain Breakdown: Coastal ADU Development

Despite negative annual cash flow, appreciation and principal paydown deliver 11.8% IRR over five years on a $1.15M coastal property with 800 sf ADU.

5-Year Equity Gain Breakdown: Coastal ADU Development
LabelEquity Position ($)
Initial Equity$341,250
Property Appreciation$239,000
Principal Paydown$47,200
Negative Cash Flow-$93,800
Total Equity Gain$533,650

The pro forma for a Huntington Beach coastal ADU project under AB 2221 exemption criteria breaks down as follows, using a representative 6,000-square-foot lot with existing 1,950-square-foot single-family residence:

Acquisition: $1,150,000 (coastal SFR, 3-bed/2-bath, 0.3 miles to beach)
ADU construction: $215,000 (800 sf detached, $240/sf all-in, includes permits, utilities, landscaping)
Financing: 25% down ($341,250), 75% loan ($1,023,750) at 7.2% interest, 30-year amortization
Total project cost: $1,365,000

Stabilized income:
Primary residence rent: $4,800/month ($57,600/year)
ADU rent: $2,900/month ($34,800/year)
Gross rental income: $92,400/year

Operating expenses:
Property taxes (1.05%): $14,330
Insurance: $3,200
Maintenance reserve (4% GRI): $3,700
Property management (5.9% GRI): $5,450
Utilities (owner-paid): $1,800
Total expenses: $28,480

Net operating income: $63,920
Debt service: $82,680 (annual P&I on $1,023,750 loan)
Cash flow: -$18,760 (year 1, negative due to debt service)

This pro forma illustrates a common challenge in coastal ADU development: debt service on acquisition plus construction often exceeds NOI in early years, requiring the owner to carry negative cash flow or structure with more equity. However, the investment thesis relies on appreciation and principal paydown rather than immediate cash yield. Over a five-year hold:

  • Principal reduction: $47,200 (loan balance drops to $976,550)
  • Appreciation (3.5% annually): $239,000 (property value rises to $1,604,000)
  • Cumulative cash flow: -$93,800 (five years of negative carry)
  • Total equity gain: $192,400 ($239,000 appreciation + $47,200 paydown - $93,800 negative cash flow)

Five-year IRR: 11.8% on the initial $341,250 equity investment—a return profile that works for long-term holders but not for developers seeking immediate cash-on-cash yields. The economics improve significantly if the owner occupies the primary residence (eliminating that unit's operating expenses and allowing mortgage interest deduction) or if the property is acquired without debt.

Common Pitfalls and Mitigation Strategies

Huntington Beach coastal ADU projects encounter predictable failure modes that experienced developers learn to avoid. The most common pitfalls include:

Misidentifying coastal zone boundaries. The CCC jurisdiction line doesn't follow street centerlines or parcel boundaries—it's a surveyed line that may bisect individual lots. A property with a street address east of PCH can still fall partially within the coastal zone if the surveyed boundary extends inland at that location. Always order a coastal zone determination from the city's Planning Division ($150–$300) before finalizing acquisition or design, rather than relying on online maps or assumptions.

Underestimating utility connection costs. Adding an ADU requires upsizing water and sewer laterals, upgrading electrical service to 200 amps (or adding a subpanel), and potentially installing a new gas line. In Huntington Beach's coastal neighborhoods, where infrastructure dates to the 1950s–1970s, these upgrades can run $18,000–$35,000—costs that novice developers often omit from initial budgets. Request a utility feasibility assessment from the city before committing to a project, and budget 12–15% of hard costs for site work and connections.

Ignoring parking requirements. While state ADU law prohibits parking requirements for ADUs within 0.5 miles of public transit, Huntington Beach interprets this narrowly: only properties within a half-mile of a fixed-route bus stop qualify. Many coastal neighborhoods fall outside this radius, triggering a requirement for one covered parking space per ADU. On constrained lots, this can force a tandem parking configuration or elimination of existing garage space—design constraints that should be resolved during feasibility analysis, not after permit submittal.

Failing to coordinate with HOA CC&Rs. Some Huntington Beach coastal neighborhoods are governed by homeowners associations with covenants, conditions, and restrictions (CC&Rs) that predate state ADU law. While AB 2221 and SB 897 override many local restrictions, they don't automatically void private CC&Rs that prohibit accessory structures or limit rentals. Review your property's CC&Rs during due diligence, and if they conflict with your ADU plans, consult with a real estate attorney about enforceability—California courts have issued mixed rulings on whether state ADU law supersedes private restrictions.

2026 Outlook and Strategic Positioning

The Huntington Beach coastal ADU landscape in 2026 will be shaped by three converging factors: continued housing demand in Orange County's beach cities, the maturation of AB 2221 exemption case law, and potential changes to CCC enforcement priorities under new state administration.

On the demand side, Huntington Beach's coastal rental market remains undersupplied relative to tenant demand, with vacancy rates below 3.2% for quality units and rent growth averaging 4.8% annually over the past three years. ADUs in beach-close neighborhoods (within 0.5 miles of the sand) command premium rents—$3.25–$3.85 per square foot vs. $2.60–$3.10 for inland Huntington Beach—because they deliver the coastal lifestyle at a more accessible price point than larger single-family rentals. This demand profile supports continued ADU development even as construction costs remain elevated.

On the regulatory side, the AB 2221 exemption is still being tested through early applications and potential appeals. The CCC has signaled that it will narrowly interpret the exemption, asserting jurisdiction over projects that technically meet the 800-sf/16-foot criteria but sit in sensitive locations (bluff edges, ESHA buffers, public view corridors). Developers should expect that the first wave of AB 2221-exempt ADUs will face closer scrutiny, with some projects potentially appealed to establish precedent. Building a paper trail—detailed compliance checklists, third-party setback certifications, photographic documentation of existing conditions—strengthens your position if a project is challenged.

Looking forward, the strategic play for Huntington Beach coastal ADU development involves acquiring properties with existing accessory structures (garages, workshops) that can be converted without triggering new construction review, or designing new ADUs that comfortably fit within AB 2221 thresholds with margin for error. A 750-square-foot detached ADU with 15-foot height is more defensible than an 800-square-foot unit at 15 feet 11 inches—the former signals intentional compliance, while the latter invites scrutiny about whether you're pushing boundaries.

For owners holding coastal SFR properties without immediate development plans, 2026 is the year to complete feasibility analysis and secure entitlements even if construction is deferred. The AB 2221 exemption and SB 897 owner-occupancy prohibition both have sunset provisions or potential legislative amendments on the horizon. Locking in an approved ADU permit—which remains valid for three years in California—preserves optionality and captures current regulatory tailwinds before the political environment shifts.

Frequently Asked Questions

Do all Huntington Beach ADUs require California Coastal Commission approval?
No. ADUs that meet AB 2221 exemption criteria—800 square feet or less (detached), 500 square feet or less (attached), 16-foot height limit, and four-foot side/rear setbacks—are exempt from coastal development permit requirements even within the CCC's coastal zone. Larger ADUs or those on bluff-edge parcels typically require CDP review, adding four to eight months to the approval timeline.
What is the difference between an ADU and a JADU in Huntington Beach?
An accessory dwelling unit (ADU) can be detached or attached and includes a full kitchen and bathroom. A junior accessory dwelling unit (JADU) is limited to 500 square feet, must be created entirely within the existing walls of a single-family residence, and may share bathroom facilities with the primary home. JADUs typically avoid triggering coastal development permits because they involve no new exterior construction. Huntington Beach allows one ADU and one JADU on the same property.
How long does it take to get an ADU permit in Huntington Beach's coastal zone?
For ADUs meeting AB 2221 exemption criteria, the city processes applications ministerially within 60 days. For larger ADUs requiring a coastal development permit, the timeline extends to eight to fourteen months, depending on whether the CDP is appealed to the California Coastal Commission. Pre-application meetings and complete submittals significantly reduce delays.
Can I rent out both my primary residence and ADU in Huntington Beach?
Yes. SB 897 prohibits cities from requiring owner-occupancy for ADUs approved after January 1, 2023, through at least January 2028. This means you can rent both the primary residence and the ADU to separate tenants without living on the property yourself, maximizing rental income from coastal properties.
What are the setback requirements for coastal ADUs in Huntington Beach?
ADUs meeting AB 2221 exemption criteria are allowed four-foot side and rear setbacks regardless of underlying zoning. Front setbacks remain at 20 feet in most residential zones. Properties on coastal bluffs face additional 25-foot bluff-edge setbacks measured from the landward edge of the bluff. Larger ADUs not qualifying for the exemption must meet standard residential setbacks, typically five feet side and 15 feet rear.
How much does it cost to build an 800-square-foot ADU in Huntington Beach?
All-in costs for an 800-square-foot detached ADU in Huntington Beach's coastal zone typically range from $200,000 to $280,000, including design, permits, utility connections, and construction. This translates to $250–$350 per square foot. JADU conversions of existing interior space cost significantly less, typically $65,000 to $95,000, because they avoid new foundation, roof, and exterior wall construction.
Navigate Coastal ADU Entitlement with Confidence Planning an ADU on your Huntington Beach coastal property? NextGen Coastal's development advisory team helps owners evaluate CCC jurisdiction, structure projects for AB 2221 exemption, and maximize returns on beach-zone accessory units. Let's discuss your entitlement strategy.
Share: Twitter Facebook LinkedIn Instagram
Chris Kerstner
Chris Kerstner
CEO at NextGen Coastal

Chris founded NextGen Coastal in 2020 to bring white-glove property management to coastal California at a 5.9% fee — roughly half the industry standard. His team manages 200+ single-family homes, small apartment buildings, and HOAs within 100 miles of the California coast. He writes these dispatches from the field on what is actually working for owners navigating ADU and JADU permits, Coastal Commission reviews, vacancy cycles, and long-term rent strategy.
